Contract administration in construction: the role, the paperwork and where AI helps

What the contract administrator does under JCT and NEC4, the paperwork involved, and how AI can take on the letters, notices and records while contract positions stay with you.

Last checked 4 October 2026

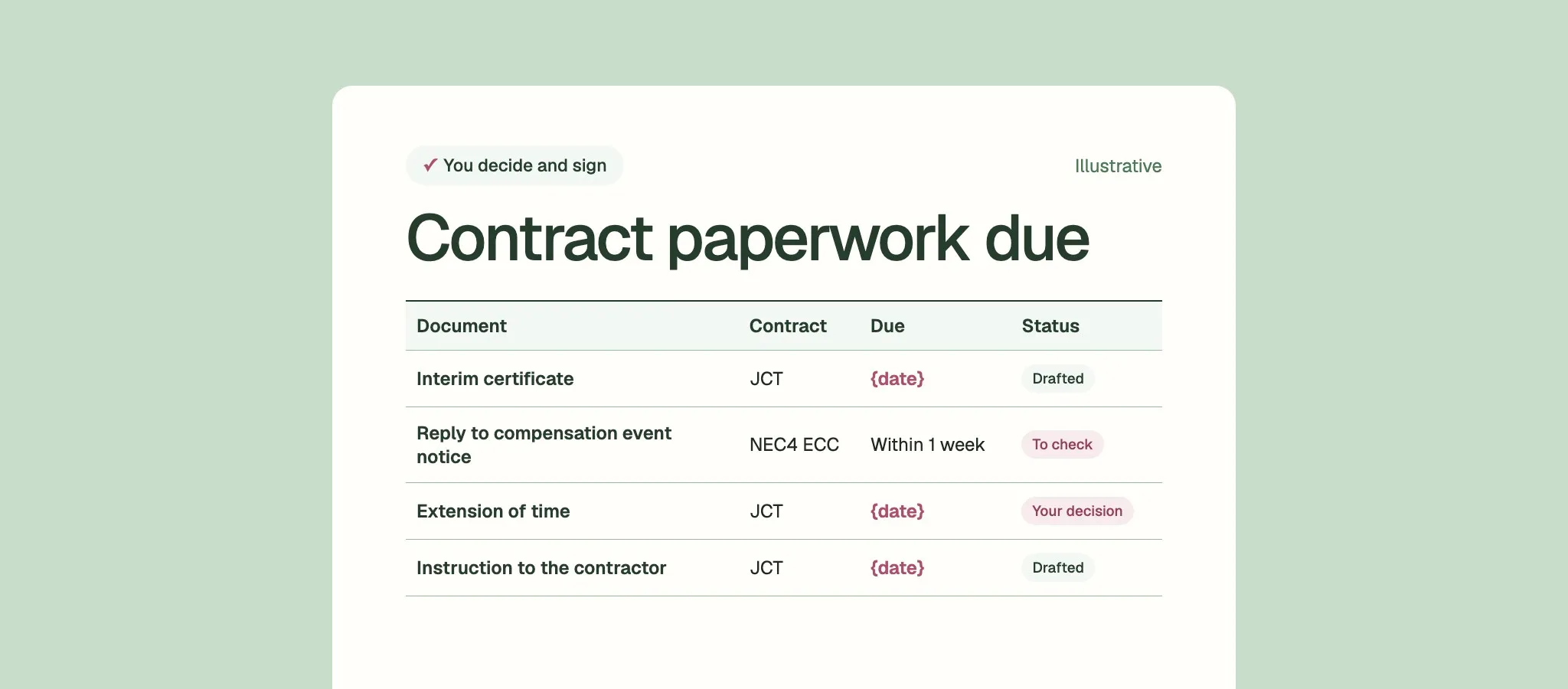

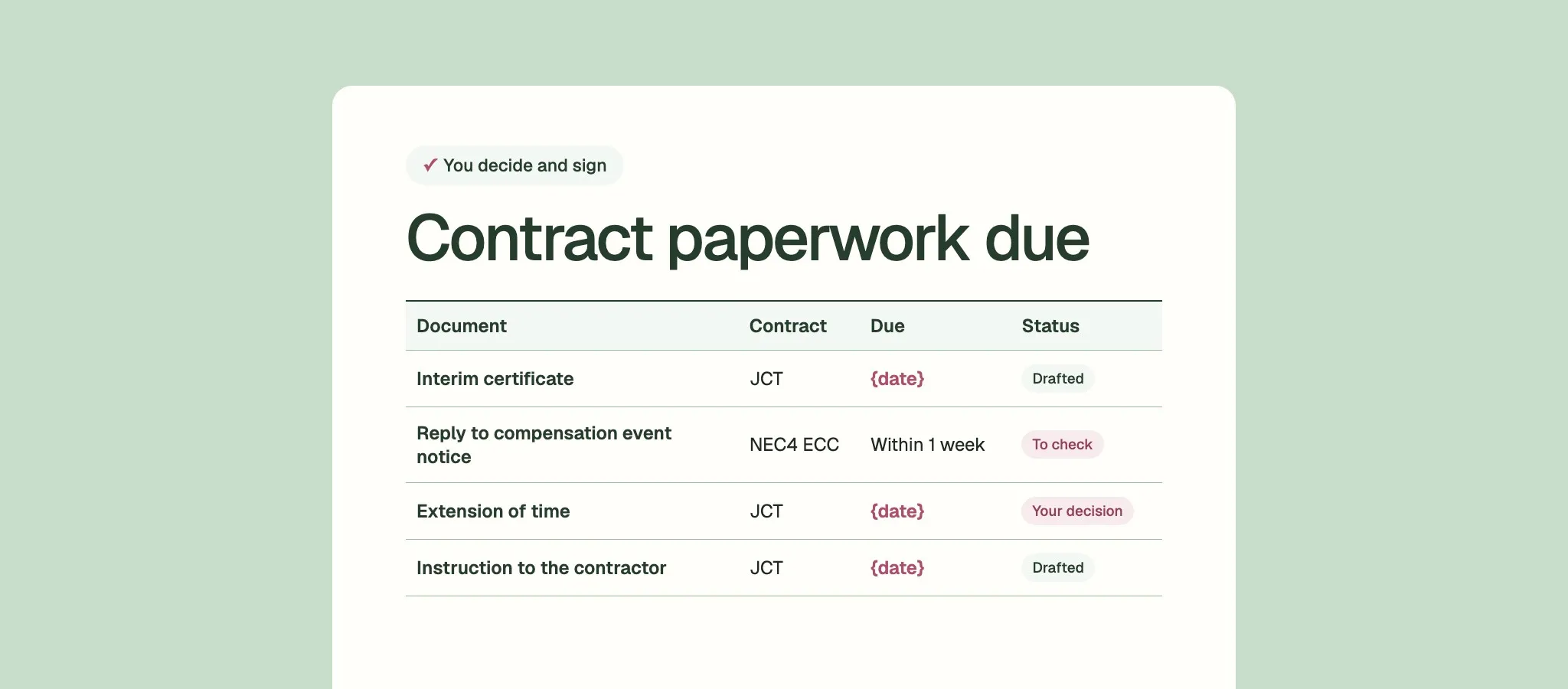

A list of contract paperwork due, with an interim certificate, a reply to a compensation event notice, an extension of time and an instruction, each with its status

Contract administration is mostly paperwork against the clock: instructions, valuations, certificates and notices, each with a date that matters. The decisions need judgement. The drafting, logging and chasing around them are where AI can give you time back.

What is contract administration in construction?

Running a building contract once it's signed: issuing instructions, valuing work, certifying payment and completion, and dealing with delays and changes.

What does a contract administrator do under JCT?

JCT's guidance describes the Architect/Contract Administrator as the professional the employer appoints to advise on and administer the contract. They're paid by the employer, but should act fairly and independently between employer and contractor when they certify, value or extend time.

  • Issue instructions to the contractor. The employer can't instruct directly.
  • Value variations and work against provisional sums.
  • Issue interim certificates for payment, and the final certificate.
  • Give a reasonable extension of time when delay is beyond the contractor's control.
  • Certify practical completion.
  • Certify when defects that appear in the rectification period have been made good.

If the person appointed isn't an architect, the contract calls them the Contract Administrator. The duties are the same.

Who administers an NEC4 contract?

NEC4's Engineering and Construction Contract names two roles, both appointed by the client. The Supervisor checks the work against the Scope, looks after tests and inspections, and notifies defects. The Project Manager handles most of the rest, including instructions, the programme, compensation events, and certifying payment and completion.

NEC4 runs on early warnings, an accepted programme and compensation events. In most cases the contractor must notify a compensation event within eight weeks of becoming aware of it, or lose the right to more time or money. The Project Manager has one week to reply to a notification unless a longer period is agreed, and a late reply can mean a notification, a programme or a quotation is treated as accepted.

Compared onJCT Standard Building or Minor WorksNEC4 Engineering and Construction Contract
Who runs it for the clientArchitect/Contract AdministratorProject Manager, with a Supervisor for tests and defects
ChangesInstructions, with variations valuedCompensation events, 21 of them listed in clause 60.1
DelayExtension of timeCompensation events, assessed against the accepted programme
PaymentInterim certificates, pay less notices and a final certificateThe Project Manager certifies payment
CompletionPractical completion and making good certificatesThe Project Manager certifies completion, and the Supervisor issues the defects certificate

What paperwork does contract administration involve?

Instructions, certificates and notices, and JCT publishes a model form for each. Under the Construction Act, a construction contract must provide for a payment notice no later than five days after each payment's due date.

The paperwork on a JCT job

Minor Works, 2024 edition

Instructions
  • Architect/Contract Administrator's instruction
Payment
  • Valuation
  • Interim certificate
  • Pay less notice
  • Final certificate
Time
  • Extension of time
  • Non-completion
  • Notice of intention to deduct liquidated damages
Completion
  • Practical completion certificate
  • Certificate of making good
JCT's model forms for the Minor Works Building Contract 2024. The Standard Building Contract pack adds more, such as section completion and partial possession.

Behind every form sit the records that justify it: site diaries, minutes, letters and, on an NEC4 job, the early warning register. Keeping them current takes time every week, and you'll rely on them in a dispute.

Where can AI help with contract administration?

With the paperwork around each decision: drafting instructions, letters and notices from your notes, keeping registers up to date, turning site diaries and correspondence into records, and flagging dates coming due.

Give it

  • Your site diary and meeting notes
  • Letters and emails on the job
  • The contract's dates and notice periods
  • Your standard letter wording

Always check

  • Every date and notice period against the contract
  • Clause references
  • The facts match the records
  • Nothing commits you to a position you haven't decided

Response times matter most under NEC4. A weekly list of what's coming due, checked by a person against the contract, is a good first job to hand to AI.

Are contract letters your biggest drain?

What should stay with people?

Anything that takes a position under the contract: whether an event entitles the contractor to more time or money, what a variation is worth, whether the work is complete, and the wording of anything you sign or send. AI can gather the facts and draft; the contract administrator decides and signs.

The AI in construction guide lists the other office jobs AI helps with, and the ones it shouldn't touch yet.

More for cost and surveying work
